Key takeaways
- Lean construction (also called lean building) is a production management approach to project delivery that maximizes value for the owner while eliminating waste, such as excess inventory, waiting, defects, rework, and unnecessary movement. It adapts lean manufacturing principles from the Toyota Production System to design and construction.
- The six principles of lean construction are respect for people, optimizing the whole, generating value, eliminating waste, focusing on flow, and continuous improvement.

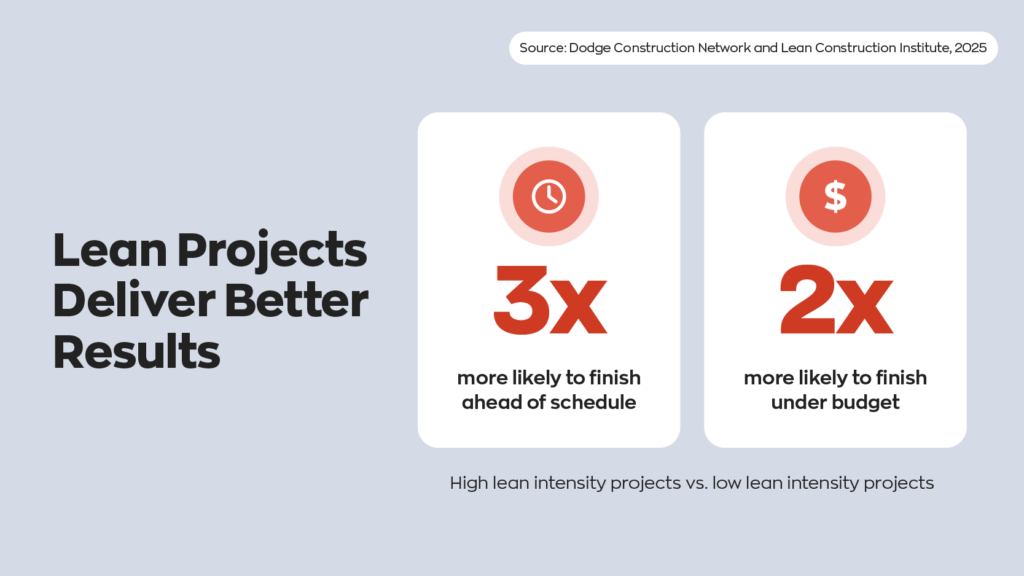

- Projects with high lean intensity are three times more likely to finish ahead of schedule and twice as likely to finish under budget than low lean intensity projects, according to research by Dodge Construction Network and the Lean Construction Institute.
- Lean construction works best on long, complex, multi-trade projects with stable teams and collaborative contracts. Small, short jobs with low upfront costs often don’t justify the planning overhead.
- The most widely used lean construction methods are huddles, collaborative BIM, visual management, and the Last Planner System, which includes pull planning.
- Inventory software supports lean construction by triggering reorders at set stock levels, tracking materials across job sites and trucks, and barcoding tools so crews spend less time waiting and searching.
If you’ve worked in construction for any length of time, you already know the feeling. The schedule slips, the budget creeps, and somehow the crew is standing around waiting on a delivery that should have arrived yesterday. You’re not imagining it, either. According to Dodge Construction Network’s 2025 research with the Lean Construction Institute, 61% of owners say their typical project finishes behind schedule, and 49% say it comes in over budget.
Lean construction is one of the most proven ways to fight back.
Not long ago, we talked about the principles of lean manufacturing. Today, we’ll take another page from the “lean” book and discuss lean construction. As you might have guessed based on their names, both concepts have a lot in common. So: what is lean construction? How does it differ from lean manufacturing? What are the principles of lean construction, and when should you be using it?
There’s a lot to go over today, so let’s get started!
What is lean construction?
Lean construction (sometimes called lean building) is a project delivery approach that maximizes value for the owner while eliminating waste across every phase of a project, from design through handover. The Lean Construction Institute (LCI) describes it as a project delivery process that uses lean methods to get the most value for stakeholders with the least waste.
But what exactly does that mean?
In short, lean construction cuts costs by reducing waste and improving how work flows from one trade to the next. In this context, “waste” means anything the owner wouldn’t willingly pay for: overstocking materials, overproducing, defects and rework, and time spent idle on the job. (More on the eight types of waste later.)
While they’re not the same thing, lean construction takes a lot of inspiration from lean manufacturing. They follow similar concepts, aiming to eliminate activities and processes that provide no added value. The big difference is that lean construction also leans heavily on collaboration. Owners, designers, general contractors, and trades plan the work together instead of handing it off in silos.
Where did lean construction come from?
Lean construction grew out of lean manufacturing, which is based on the Toyota production system. Researchers and contractors adapted those ideas to construction in the 1990s, and they’ve been refining them ever since.
How lean construction relates to lean manufacturing
There are two core components, or “pillars,” to lean manufacturing: just-in-time (JIT) and “Jidoka.”
JIT is a system where you only order or produce what you need when needed. Instead of stocking the shelves, companies will only manufacture or order products when necessary. While this system does have its limitations, it reduces the amount of capital tied up in the warehouse and increases efficiency.
Jidoka, on the other hand, is a bit different. It’s a Japanese term that roughly translates to “automation with a human touch.” Essentially, Jidoka means stopping work the moment something goes wrong, so the problem gets fixed at its source instead of being passed down the line.
Neither of these terms applies completely to lean construction, but the underlying principles do. Under the doctrine of JIT, contractors purchase materials in smaller quantities but more often, timed to when each phase of work actually needs them.
That’s easier said than done, though. In our State of Inventory Management 2026 survey of 400 operators, just 28.5% said they use JIT replenishment, making it the least-used method we asked about. And among the 108 construction and trades operators we surveyed, 85% now buy ahead of expected shortages or price increases, the opposite of JIT. With material costs climbing for 69% of them, that’s a rational choice. It just means lean purchasing takes deliberate planning.
Jidoka, on the other hand, applies a bit strangely. Construction projects are still mostly manual, so instead, contractors build quality in at the source. Crews stop and fix a problem before the next trade covers it up, and teams automate the error-prone admin work that causes mistakes in the first place. For example, tools like inFlow help with invoicing and inventory tracking tasks, so counts and orders don’t depend on someone retyping numbers from a clipboard.

How lean moved into construction
Lean construction became its own discipline in the early 1990s:
- 1992: Finnish researcher Lauri Koskela published a report applying the new production philosophy from manufacturing to construction.
- 1993: The International Group for Lean Construction (IGLC) held its first meeting and coined the term “lean construction.”
- 1997: Glenn Ballard and Gregory Howell co-founded the Lean Construction Institute in the United States. LCI went on to develop the Last Planner System, one of the most widely used lean construction methods today.
Why didn’t contractors just copy Toyota? Because a jobsite isn’t a factory. Every project is a one-off, the “factory” moves to a new site each time, and dozens of independent companies have to coordinate on the same build. Lean construction adapts lean thinking to those realities.
What are the 6 principles of lean construction?
The six principles of lean construction, as taught by the Lean Construction Institute, are respect for people, optimizing the whole, generating value, eliminating waste, focusing on flow, and continuous improvement. Here’s what each one means on a real project:
- Respect for people: Everyone on the project, from the owner to the apprentice, has knowledge worth hearing. Lean teams build trust, invite input from the people doing the work, and hold each other to the commitments they make.
- Optimize the whole: A lean team judges success by the whole project, not by one trade’s piece of it. Finishing your scope early doesn’t help if it leaves the next crew waiting or working around your mess.
- Generate value: The concept of value here refers to identifying the essential processes and materials needed to meet the customer’s needs, while eliminating anything unnecessary. Value is defined by the owner, not by the contractor.
- Eliminate waste: A lean system aims to reduce waste in all forms, whether it’s materials, waiting times, defects, or rework.
- Focus on flow: With proper planning and scheduling, you can achieve an uninterrupted workflow that reduces bottlenecks. Work, materials, and information should move smoothly from one trade to the next.
- Continuous improvement: Lastly, a lean system aims to learn from past experiences, identify issues in the process, and improve upon them. Lean is never “done.”
You’ll often see pull planning and the Last Planner System listed alongside these principles. They’re closely linked, but they’re methods for putting the principles into practice rather than principles themselves. We’ll cover both in the tools section below.
What are the 8 types of waste in construction?

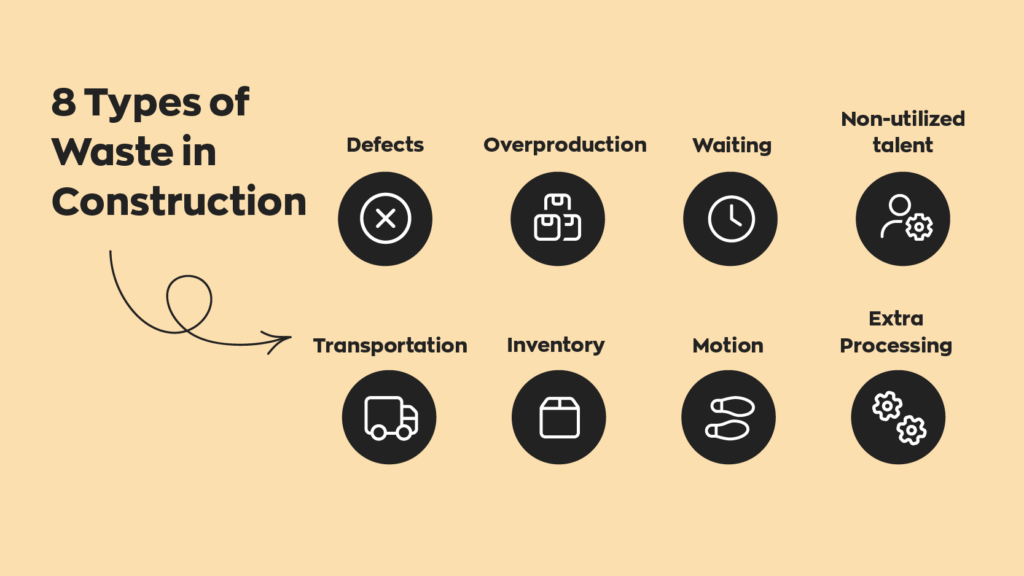

The eight types of waste in lean construction are defects, overproduction, waiting, unused talent, transportation, inventory, motion, and extra processing. (Some sources list seven, leaving out unused talent. Either way, the goal is the same.) A handy way to remember them is the acronym DOWNTIME:
| Type of waste | What it looks like on a jobsite |
|---|---|
| Defects | Work that fails inspection or has to be torn out and redone |
| Overproduction | Prefabbing or installing work before the next trade is ready for it |
| Waiting | Crews standing idle for materials, equipment, inspections, or information |
| Non-utilized talent | Ignoring the trades’ input on sequencing, methods, or constructability |
| Transportation | Hauling materials between the yard, the shop, and the site more than necessary |
| Inventory | Excess materials sitting on site, getting damaged, stolen, or tying up cash |
| Motion | Workers walking back and forth to find tools, materials, or drawings |
| Extra processing | Redundant paperwork, double data entry, or more finishing than the spec requires |
These wastes add up fast. A PlanGrid and FMI survey of nearly 600 construction professionals found they spend 35% of their time on non-optimal work like hunting for project information, resolving conflicts, and fixing mistakes. That’s about 14 hours per person, every week. Rework alone costs a median of roughly 9% of total project cost once direct and indirect costs are combined, according to research from the Navigant Construction Forum.
Material shortages feed several of these wastes at once. In our Stocked Out survey of 1,000 U.S. buyers, 365 of whom were buying for work, 45% of business buyers needed a second trip or shipment after a stockout, 41% saw production slow or stop, and 40% sent a technician who couldn’t finish the job on the first visit. That’s waiting, transportation, and motion, all from one missing part.

Lean construction vs. traditional construction
The biggest difference between lean and traditional construction is how work gets planned. Traditional projects push work through a top-down schedule. Lean projects pull work through based on what the next trade actually needs, with everyone planning together.
| Traditional construction | Lean construction | |
|---|---|---|
| Planning | Top-down master schedule set by the general contractor | Collaborative pull planning with the trades doing the work |
| Focus | Each party optimizes its own scope | The whole project is optimized together |
| Materials | Bulk orders, often bought upfront | Phased, smaller deliveries timed to the work |
| Trade involvement | Trades brought in after design is set | Key trades involved early, often before design development |
| Contracts | Fixed-price or design-bid-build, with risk pushed downstream | Collaborative contracts such as IPD that share risk and reward |
| Problems | Fixed when they’re found, often late | Surfaced and fixed at the source, as soon as they appear |
| Measuring success | Did we hit the budget and schedule? | Plus: how reliably did we keep our weekly commitments? |
That said, it’s not all or nothing. Plenty of contractors use lean practices on traditional contracts, and as you’ll see below, many of them don’t even realize it.
How does lean construction improve project efficiency?
Lean construction improves project efficiency by cutting waste, making schedules more reliable, and keeping capital out of idle inventory. And unlike a lot of business buzzwords, it has the data to back it up.
Construction badly needs the help. Globally, construction labor productivity grew just 1% a year over two decades, compared with 2.8% for the world economy as a whole, according to the McKinsey Global Institute. Here’s where lean makes a measurable difference.
Projects finish on time and on budget more often
Research by Dodge Data & Analytics, sponsored by the Lean Construction Institute, found that projects with high lean intensity (meaning they used many lean methods together) were three times more likely to finish ahead of schedule and twice as likely to finish under budget as low lean intensity projects. Dodge’s 2025 summary of six surveys also found that contractors with high lean intensity finished more of their projects on or ahead of schedule, on both their best and typical jobs.
Contractors feel the difference, too. In an earlier McGraw Hill Construction study of contractors using lean practices, 84% reported higher quality construction and 80% reported greater customer satisfaction. Another 77% saw greater productivity, and 77% saw improved safety.

Capital stays in the bank, not in the yard
The biggest financial advantage of lean construction is how it optimizes the flow of capital. Buying small portions of materials keeps more capital in the bank and can help save on costs in the long term. Optimizing workflow, movement of equipment, and other processes also goes a long way in increasing profits.
Idle inventory isn’t free. More than half of the construction and trades operators in our construction site inventory survey estimate their annual holding costs at 11% or more of inventory value. That’s money sitting in a yard or on a truck instead of in the business.
Phased purchasing limits your risk
Phased purchasing has its own advantages as well. Because many construction projects are long-term endeavors, most projects are susceptible to change. If you purchase every required material at the beginning of a project, and it ends up getting cancelled, you end up eating a lot of extra costs. Buying in phases also helps mitigate costs when specifications change mid-project.
Smaller batches help ensure quality
Cutting shipments into different segments also helps ensure quality. When materials arrive in smaller batches tied to specific phases of work, defects and damage are caught sooner, before they’re repeated across the whole job. Segmenting deliveries and deadlines this way also helps budget time better and goes a long way in eliminating schedule clashes.
What are the challenges of adopting lean construction?
The biggest challenges of adopting lean construction are the culture shift it requires, getting every company on the project to buy in, and the risk of running lean purchasing when material prices and supply are unpredictable. As with any system, there are advantages and disadvantages. We can’t really tell you whether or not you would benefit from implementing a lean workflow. Each business has its own unique process, and some are more suited to this system than others.
It demands discipline
While the lean construction principles are relatively simple, the end goal is continuous improvement, which never really ends. That demands attention to detail, which can be challenging to maintain for long periods.
Not everyone on the project will be on board
Lean works best when every company on the project commits to it, and that’s the hardest part. In Dodge’s 2025 research, 40% of the most experienced lean practitioners said they expect pushback from other project team members. Many people also underestimate what lean can do: on average, 55% of those who don’t use lean don’t realize it leads to better outcomes.
JIT purchasing carries supply risk
Because lean construction works on a JIT basis, it’s not suitable for every project. This is especially true because even small construction projects involve many different materials. Prices of materials can change quickly, and while rare, others can become scarce at a moment’s notice. That’s exactly why so many contractors are buying ahead right now, and why lean purchasing needs accurate, up-to-date inventory data to work.
The transition takes time
Implementing a lean system can also prove burdensome. Because it introduces new processes and more coordination, going from a traditional method to a lean one can result in errors. In some instances, it can also be challenging to adjust to a new workflow.
That being said, even if you don’t implement a full lean system, you can learn something from its principles. Optimizing workflows is a big part of increasing profits, and automating menial tasks goes a long way in remedying this.

When should you use lean construction?
Lean construction is best suited to long, complex, multi-trade projects with stable teams, while a traditional approach often makes more sense for small, quick jobs with low upfront costs. While lean construction is a worthwhile cost-saving measure, it’s not suitable for every project.
Projects where lean works best
It’s best to use lean construction on long-term projects that have a consistent schedule. Because the construction itself takes a lot of time, it’s easier to section off costs. Material shipments are easier to schedule, and small orders can mitigate excessive loss if plans change.
Lean also shines on complex builds where many trades have to coordinate, such as hospitals, labs, and large commercial projects. (If you’re not sure where your work falls, our overview of the different types of construction is a good place to start.) These projects get the most out of collaborative planning, and owners often pair them with collaborative contracts like integrated project delivery (IPD), where the owner, designer, and builder share risk and reward.
Here’s a quick gut check. Lean is a strong fit when:
- The project runs for months or years, not days or weeks
- Several trades depend on each other’s work to move forward
- The owner is willing to involve key trades early
- Your team works together on repeat projects and can improve from one job to the next
When a traditional approach makes more sense
It’s best to use a traditional construction model for small projects with low initial costs. These projects tend to be small-scale and don’t take as much time to complete. As a result, it’s often better to purchase everything all at once after agreeing to the scope. Short, simple jobs with a clear scope also tend to work well with a straightforward agreed-upon price, and quick projects require swift responses. In cases like these, establishing a full lean system takes more effort than it’s worth.
That doesn’t mean small contractors should ignore lean entirely, though. Individual practices like daily huddles, cycle counting, and keeping a tidy, well-organized site cost almost nothing and work on jobs of any size.
What tools and methods support lean construction?
The most widely used lean construction methods are daily huddles, collaborative BIM, visual management, and the Last Planner System. In Dodge’s most recent survey of owners, designers, and contractors, 65% had used collaborative BIM in the last three years, 61% had used huddles, and 51% had used visual management. Here are the methods worth knowing.
Last Planner System
A key component of lean construction is the Last Planner System (LPS), which is when you involve the tradespeople or subcontractors in the planning and coordination. Developed by the Lean Construction Institute, it’s built on a simple idea: the people closest to the work (the “last planners”) know best what can realistically get done.
LPS works at four levels:
- Master (milestone) planning: Sets the big project milestones.
- Phase pull planning: Trades work backward from each milestone to plan the handoffs between them.
- Lookahead planning: Looks a few weeks out to clear constraints, such as missing materials, drawings, or inspections, before they hold up work.
- Weekly work planning: Crews commit to the tasks they’ll finish that week, then track how many commitments they actually kept.
That last measure is called percent plan complete (PPC), and it’s how lean teams spot problems in their planning before they show up in the schedule.
Pull planning
Pull planning allows activities to “pull” work through the building process based on progress and needs. Instead of starting at day one and pushing tasks forward, the team starts at a milestone and works backward, with each trade saying what it needs from the trade before it. It’s usually done together in one room with sticky notes on a wall, and in Dodge’s research, 43% of respondents had used phase pull planning in the last three years.
Target value design and integrated project delivery
Target value design (TVD) flips the usual order of design and estimating. The team agrees on a target cost upfront, then designs to that number instead of designing first and hoping it fits the budget. It’s often paired with integrated project delivery (IPD), a contract that puts the owner, designer, and builder on the same team with shared risk and reward.
5S and visual management
5S is a lean method for keeping work areas organized: sort, set in order, shine, standardize, and sustain. On a jobsite, that means clearly marked material staging areas, tools stored where crews can find them, and a site clean enough to spot problems. Visual management goes hand in hand with it, using boards, color codes, and labels so anyone can see the status of the work at a glance.
Inventory and materials management software
While most construction work is still done by hand, you can still do a lot to optimize your workflow. You can automate other parts of the work, such as invoicing or ordering materials. And there’s plenty of room to improve. In our survey of 108 construction and trades operators, 86% track inventory in spreadsheets and 81% use no dedicated inventory software at all. Not surprisingly, 52% said inventory accuracy is the area that most needs improvement.
inFlow’s field management software handles that side of lean construction:
- Reorder points by location: Set a minimum stock level for each item at each location, and inFlow emails you a low-stock list on the days and times you choose. Not sure where to set them? The Recommended Reorder Point report suggests a starting point based on your history. (Our guide to the reorder point formula explains the math.)
- One-click reordering: The Reorder Stock screen generates purchase orders or stock transfers for everything that’s running low, which makes smaller, more frequent orders practical.
- Job sites and trucks as locations: Track materials at the yard, on each truck, and at each site, then move them with stock transfers so every crew sees the same numbers.
- Barcode scanning: Our inventory and barcoding systems remove the clipboard-to-spreadsheet data entry where most counting errors creep in. With inFlow Stockroom, crews can scan materials in and out from their phones.
- Tool and equipment tracking: You can even put barcodes on your most expensive tools and equipment and track your assets by assigning them to people or job sites, so you always know who has what and where it is.
How to implement lean construction on your projects
The easiest way to implement lean construction is to start small: pick one project, one or two practices, and one measure of success, then build from there. Here’s a practical way to get started.
- Map where your waste is. Walk through a recent project and note where crews waited, where materials sat unused, and where work had to be redone. The DOWNTIME table above is a good checklist.
- Bring the trades in early. Invite key subcontractors into planning before the schedule is locked, so the people doing the work help shape it. (Our guide on how to manage construction projects covers the basics of coordinating a project team.)
- Start with huddles and pull planning. A 15-minute daily huddle and one pull planning session per phase are low-cost ways to see results quickly.
- Track your commitments. Measure percent plan complete each week. If crews keep missing commitments, dig into why before the next week’s plan.
- Phase your material purchases. Order materials in smaller batches timed to each phase of work, and set reorder points so you know when to buy before you run short.
- Get your inventory data right. Lean purchasing only works if you trust your counts. Regular cycle counts and barcode scanning keep numbers accurate between jobs.
- Track costs by job. Construction job costing shows which phases ran over and where waste is really costing you.
- Review and repeat. After each project, hold a short retrospective on what worked, what didn’t, and what you’ll change next time. That’s continuous improvement in action.
You don’t need to do all eight at once. Even a couple of these steps can make your next project run noticeably smoother.
FAQ
Is lean building the same as lean construction?
Yes. Lean building and lean construction are two names for the same approach: applying lean manufacturing principles, originally developed by Toyota, to the design and construction of buildings and infrastructure. You may also see it called lean project delivery or lean design and construction. In every case, the goal is to deliver more value to the owner while eliminating waste such as waiting, rework, and excess inventory.
What is the Last Planner System in lean construction?
The Last Planner System (LPS) is a collaborative planning method developed by the Lean Construction Institute. Instead of following a top-down schedule, the trades doing the work plan it together across four levels: master planning, phase pull planning, lookahead planning, and weekly work planning. Crews commit only to work they can actually finish, and the team tracks percent plan complete (PPC) each week to make planning more reliable.
What lean construction certifications are available?
The best-known lean construction credential is the Associated General Contractors of America’s Certificate of Management-Lean Construction (CM-Lean). To earn it, you complete AGC’s Lean Construction Education Program, now in its second edition, then pass the CM-Lean exam. As of January 1, 2024, AGC no longer requires credential renewals, so once you earn it, it stays valid. The Lean Construction Institute also offers lean training and courses.
What are the best books and courses for learning lean construction?
Popular starting points include AGC’s Lean Construction Education Program and the courses offered by the Lean Construction Institute. For books, The Lean Builder by Joe Donarumo and Keyan Zandy is a favorite among field leaders. Written as a story about a superintendent learning lean on the job, it won the 2020 Shingo Institute Publication Award and has sold more than 20,000 copies.
Can small contractors use lean construction?
Yes. Small contractors may not need a full lean system with collaborative contracts, but many lean practices cost almost nothing to adopt. Daily huddles, 5S on job sites, regular cycle counts, and phasing material purchases instead of buying everything upfront all reduce waste on jobs of any size. Start with one practice, measure the result, and add more as your team gets comfortable.
What software is best for lean construction management?
Lean construction usually calls for two kinds of software. Last Planner and pull planning platforms digitize scheduling, commitments, and percent plan complete. Inventory management software like inFlow covers the materials side: reorder points and low-stock alerts, stock tracked across yards, trucks, and job sites, and barcode scanning for materials and tools. Together, they keep both the work and the materials flowing.
